Five hours to a shift planner the store corrected 224 times
My store failed a big-retailer audit in July. I built the missing piece in five hours, put it on the floor the next morning, and let a month of real shifts rewrite it.
What shipped
- Version one on the shop floor in five hours, 2 August 2026.

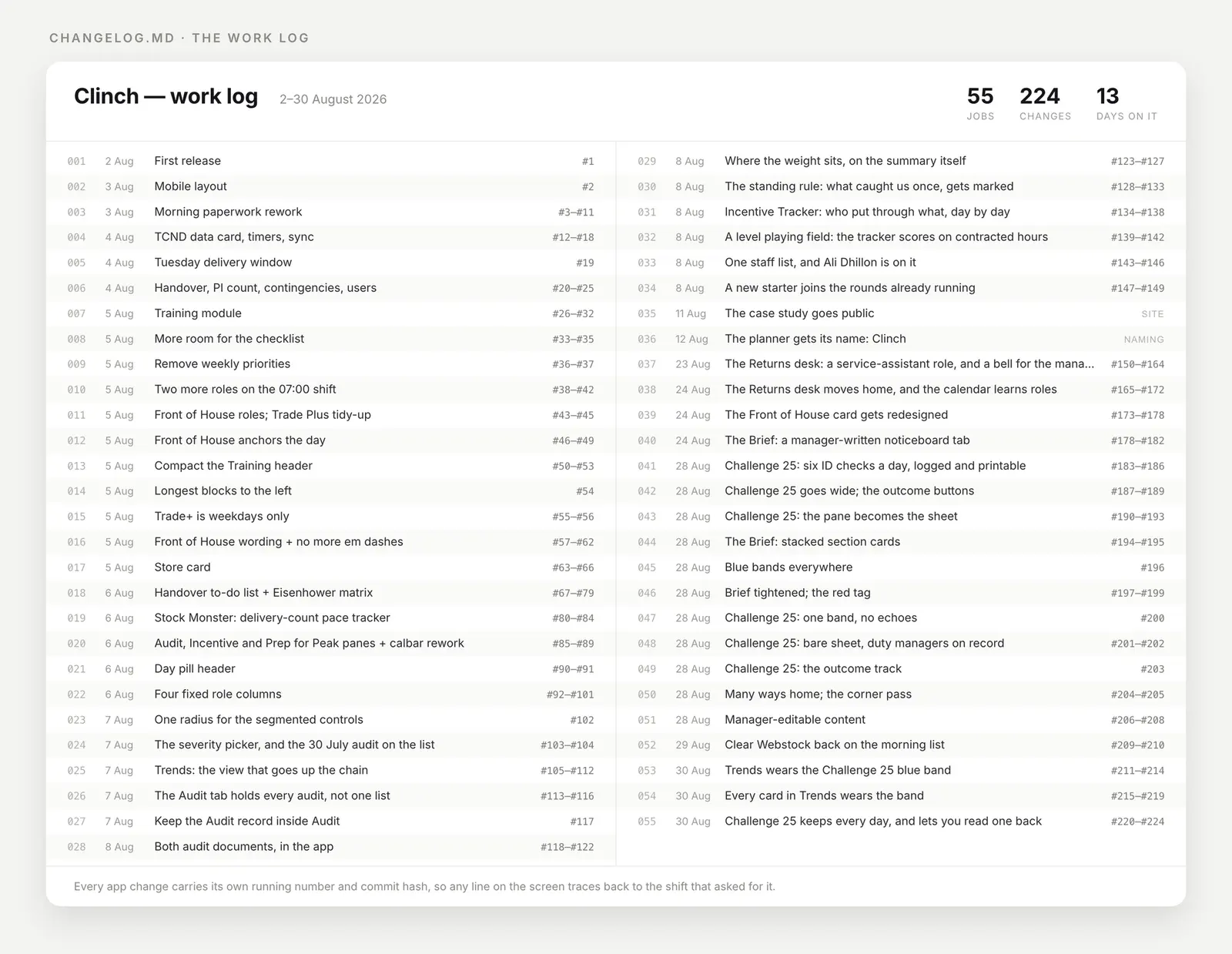

- 55 build jobs and 224 logged changes by 30 August, each one traceable to a shift.
- Handover, training and audit actions now survive the date change. Every tick carries a name and a time.
- Store result: not measured yet.

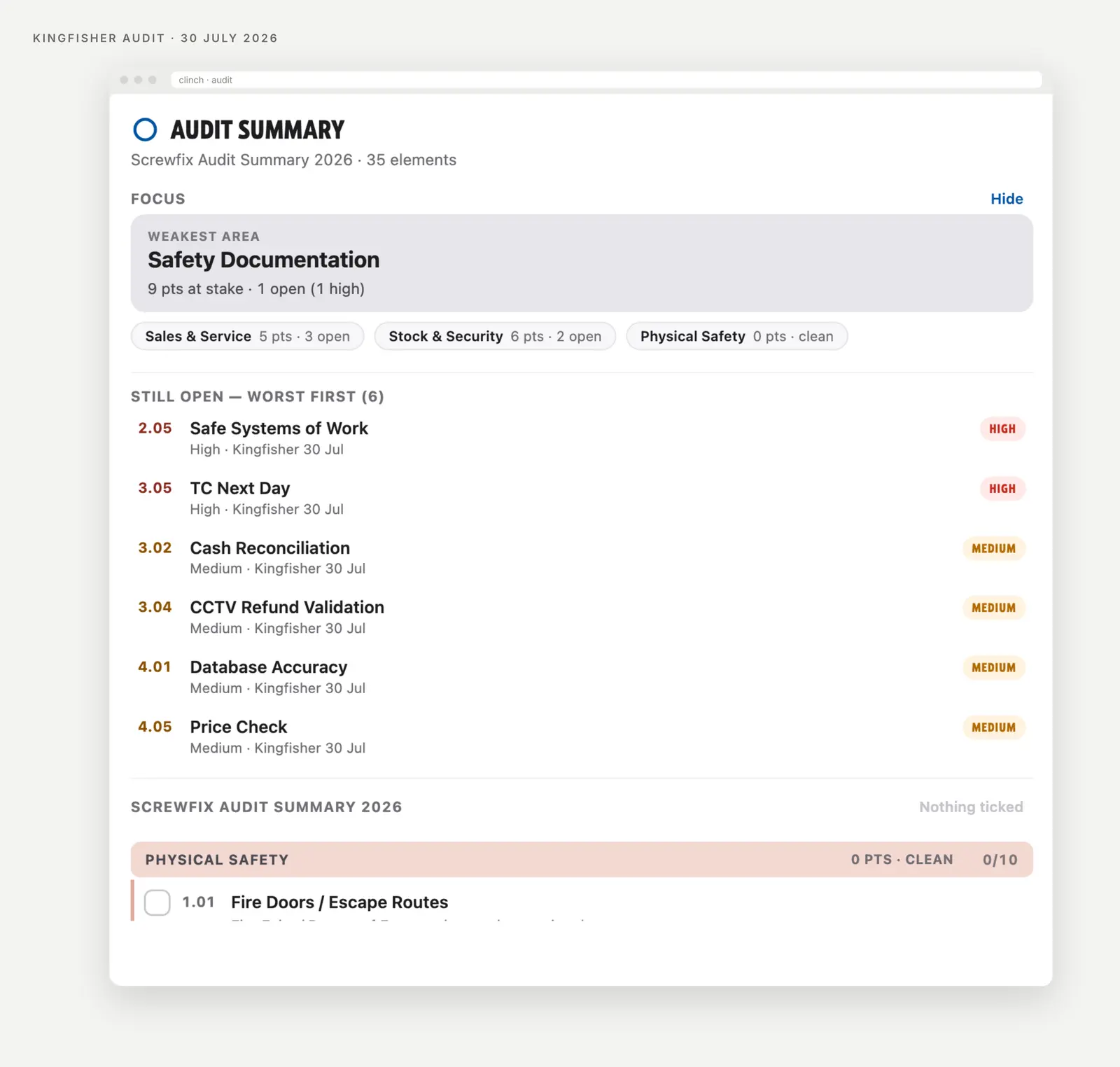

The audit named six failures. They had one cause.
Two highs. Four mediums. Safe systems of work, cash reconciliation, CCTV refunds, database accuracy, price checks.
Nobody had skipped the work. The work had worked loose.
Our procedures lived in company systems, laminated sheets, emails, calendars and the heads of five experienced managers.
No single place could say what mattered now, what was already done, or what the next manager was about to inherit.
Three ways a busy shift loses work
- No plan for the shift. A 7am opening holds fire doors, cash, red orders, stock, weekly checks and the team brief. The customer at the counter wins. A safe count sits quietly.
- A tick proved nothing. It could not say who did the job, when, how long it took, or whether someone hit Stop by mistake.
- Unfinished work vanished at midnight. Jobs built up all morning, then landed on the late manager with no owner and no context.
So the design question got simple. How do I take the week out of managers' heads and put it where the whole shift can see it?
Five hours to version one. Then the store took over.

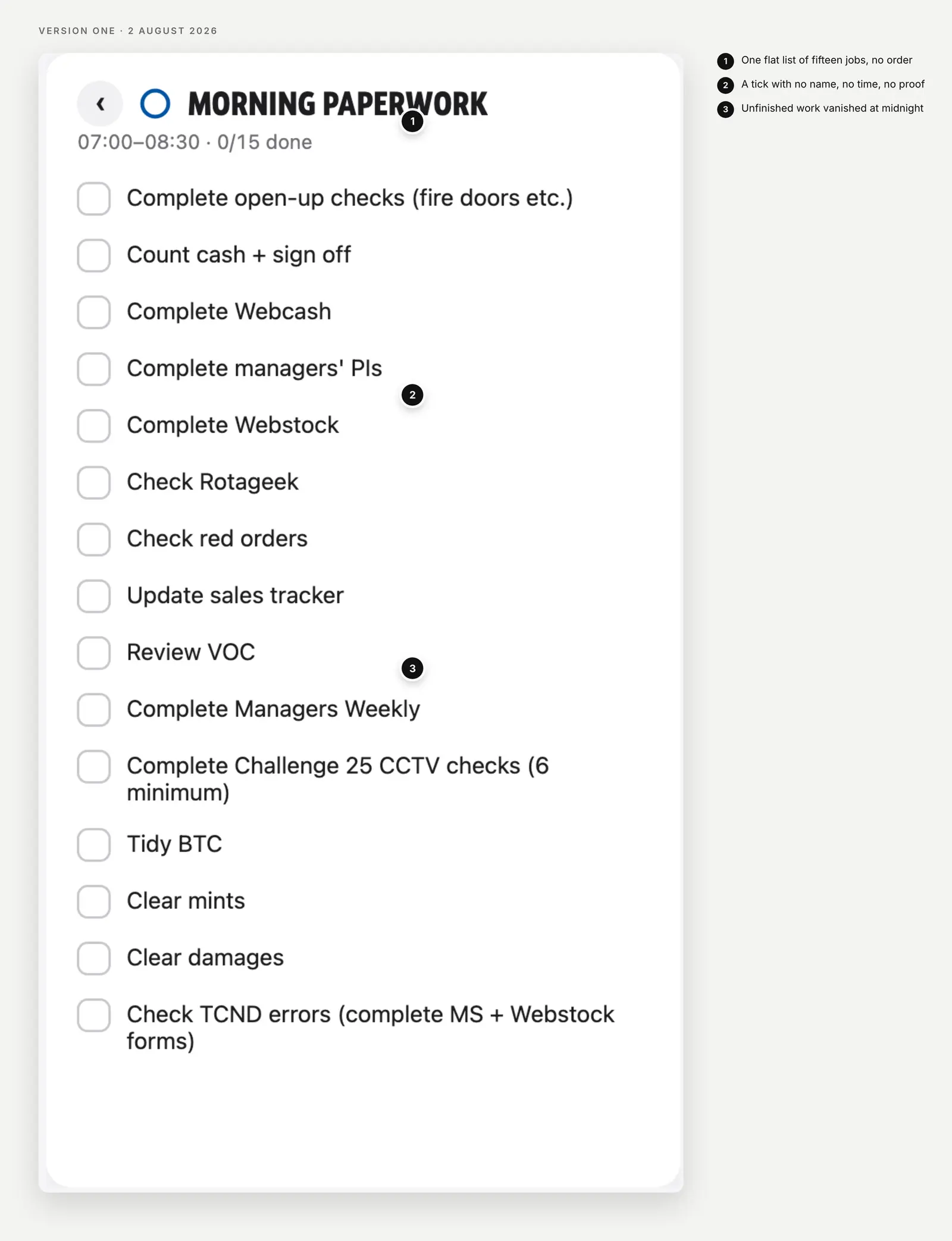

I shipped version one on 2 August after roughly five hours of AI-assisted build. A weekly calendar, timed blocks, checklists.
Testing started the next morning. It was wrong in useful ways.
The people using it rewrote the plan

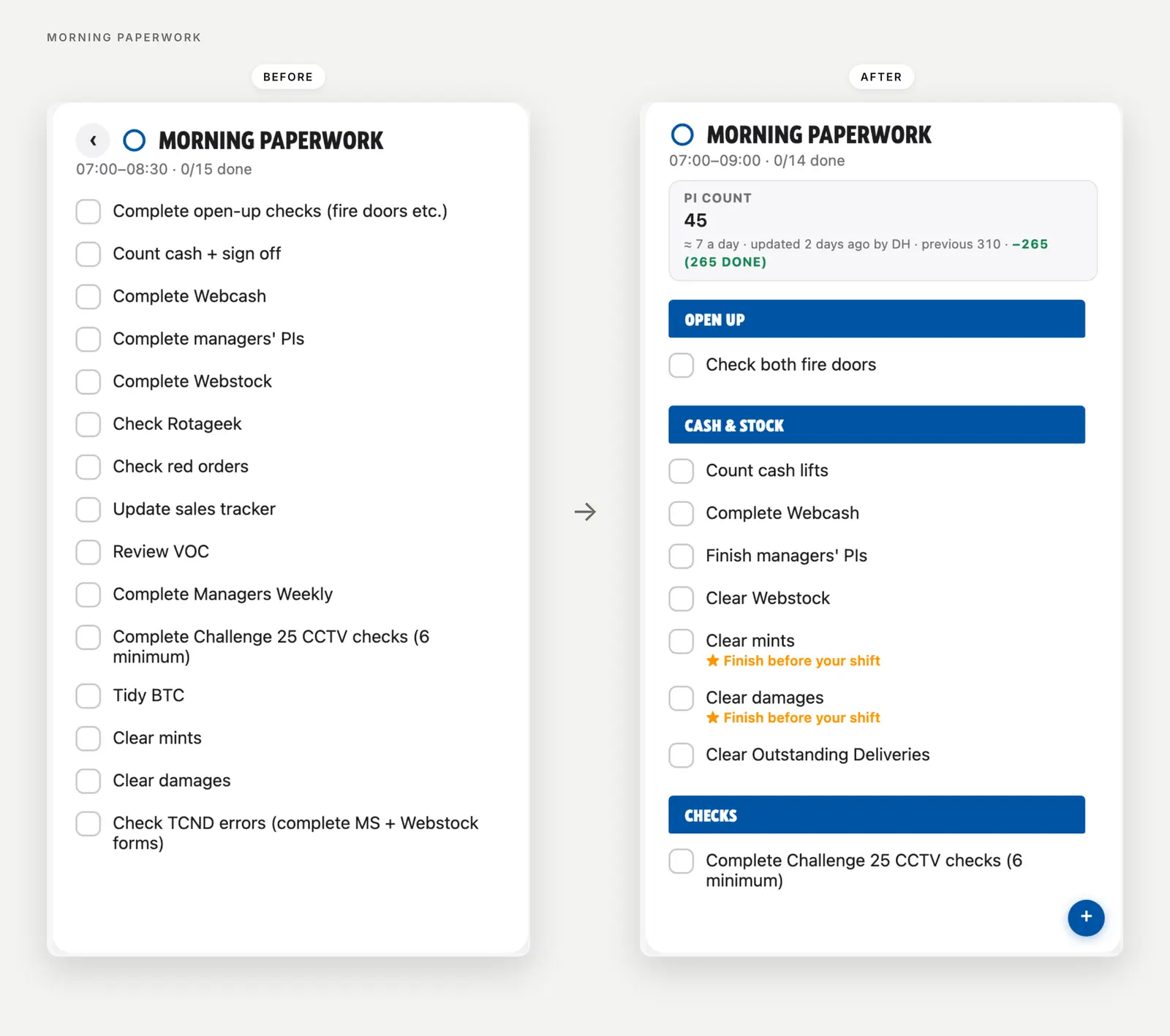

Morning Paperwork needed until nine, not half eight. The trading check belonged on Monday. Two task lists became one.
Timing and wording turned out to be the product. A planner can look tidy and still tell the store to do the wrong thing.

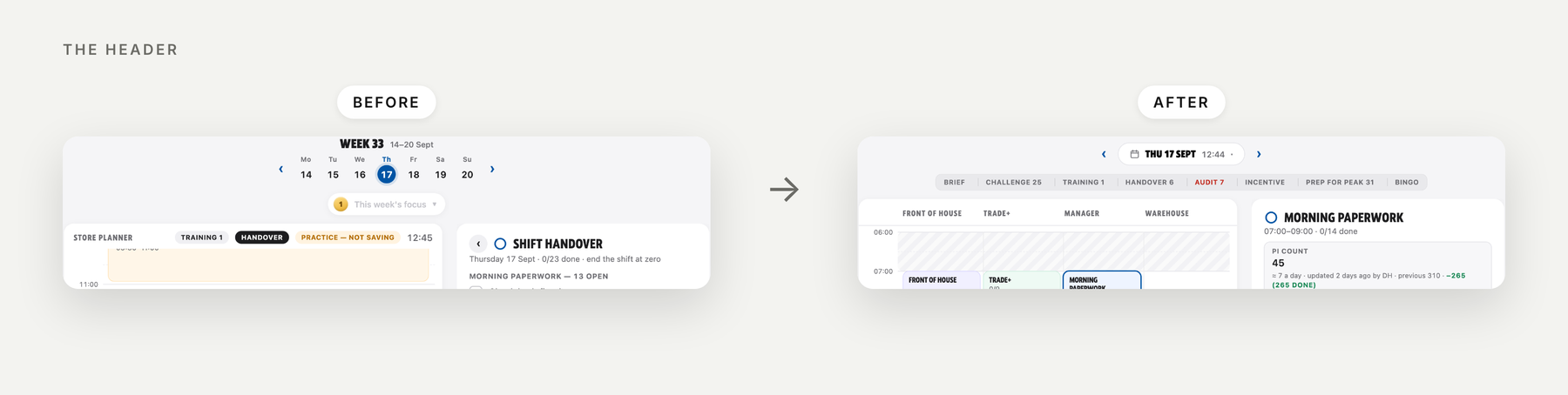

I deleted as much as I added. The weekly focus pill competed with the calendar, so it went. So did a notes box and every duplicate control.
A tick became a data card

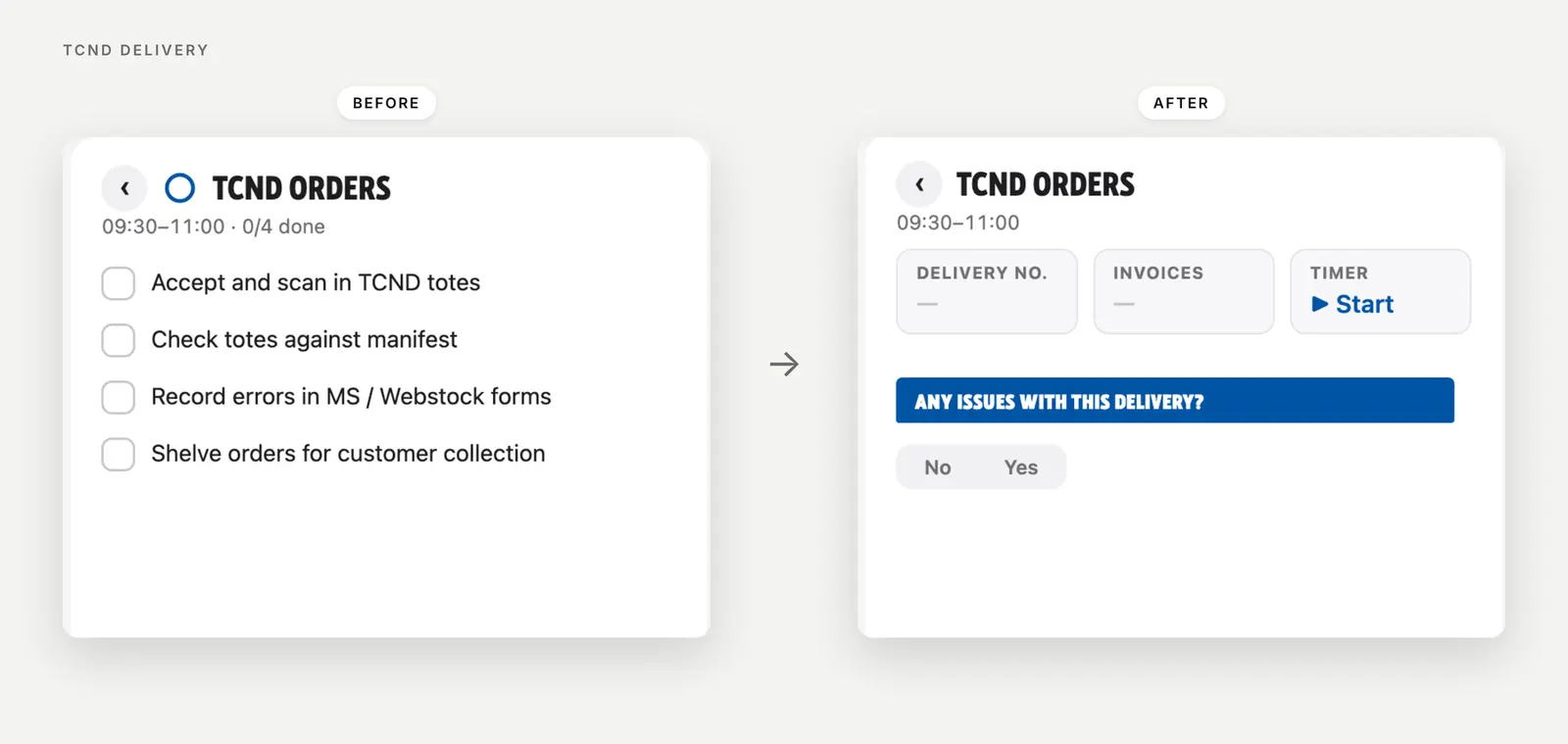

Deliveries now record the delivery number, the invoice count, missing SKUs and elapsed time. The timer asks before it saves, so a bad tap can be undone.

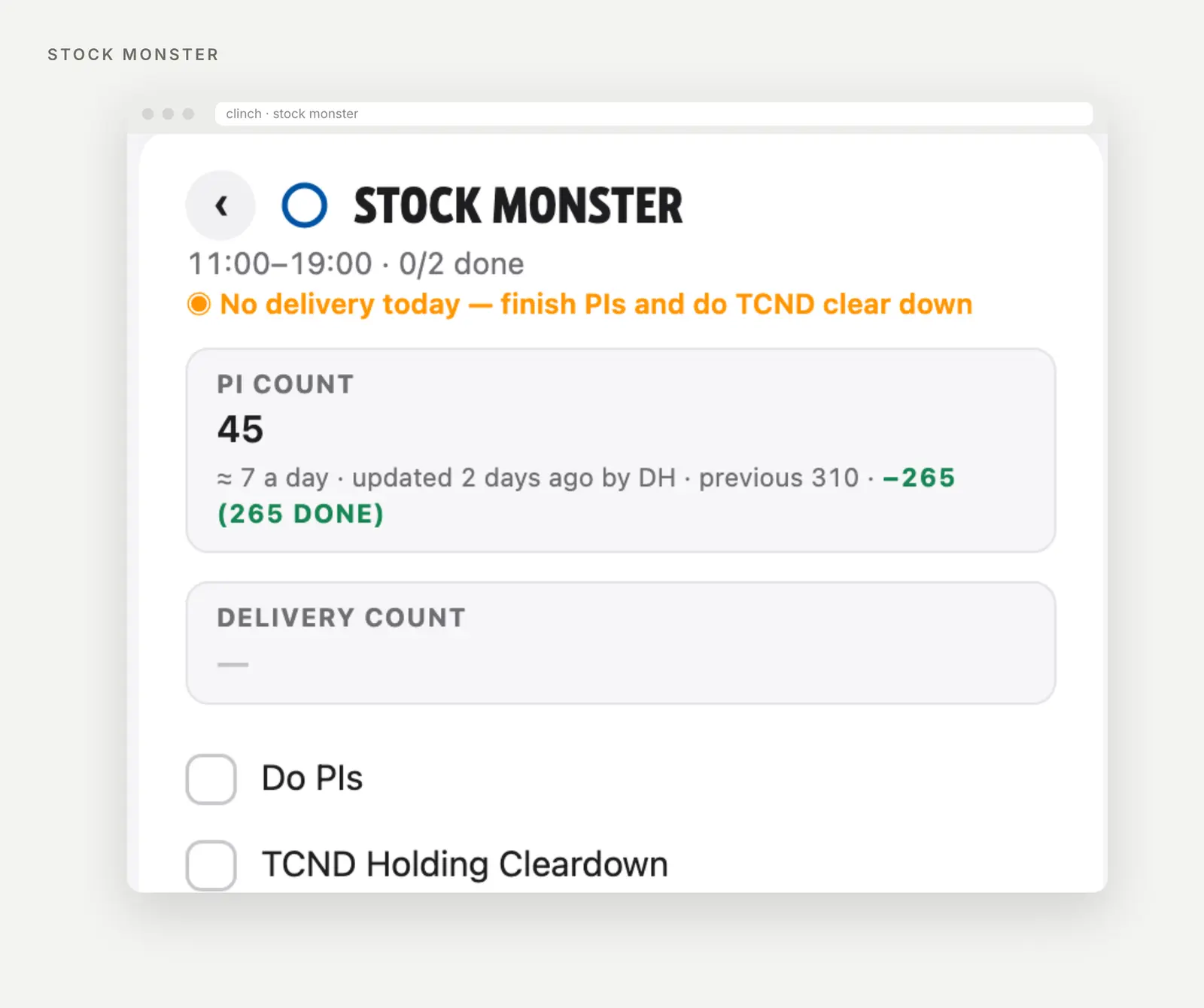

Stock Monster does the same for the clear-down. Managers enter the stock left through the day.
Each job got the right kind of memory

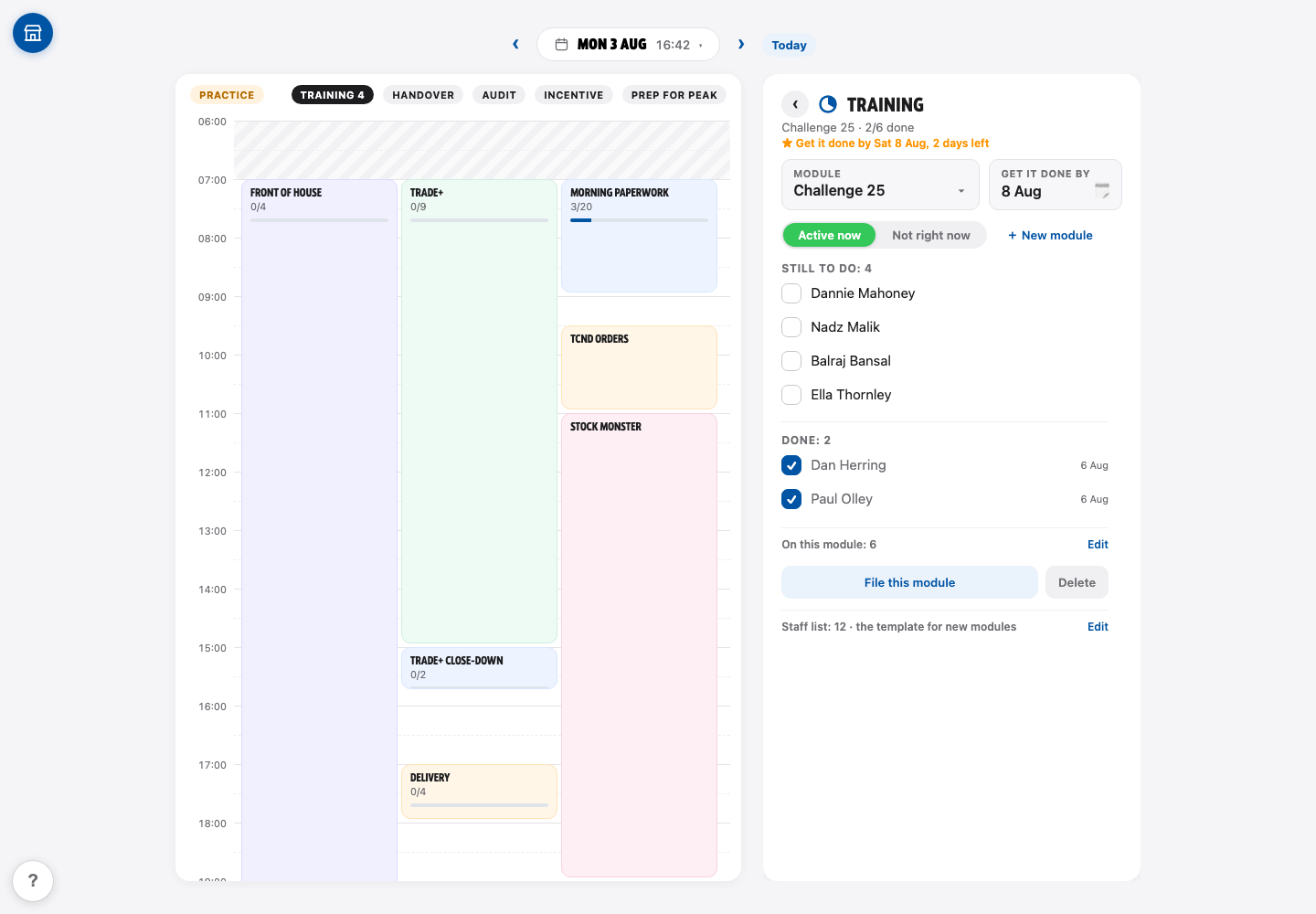

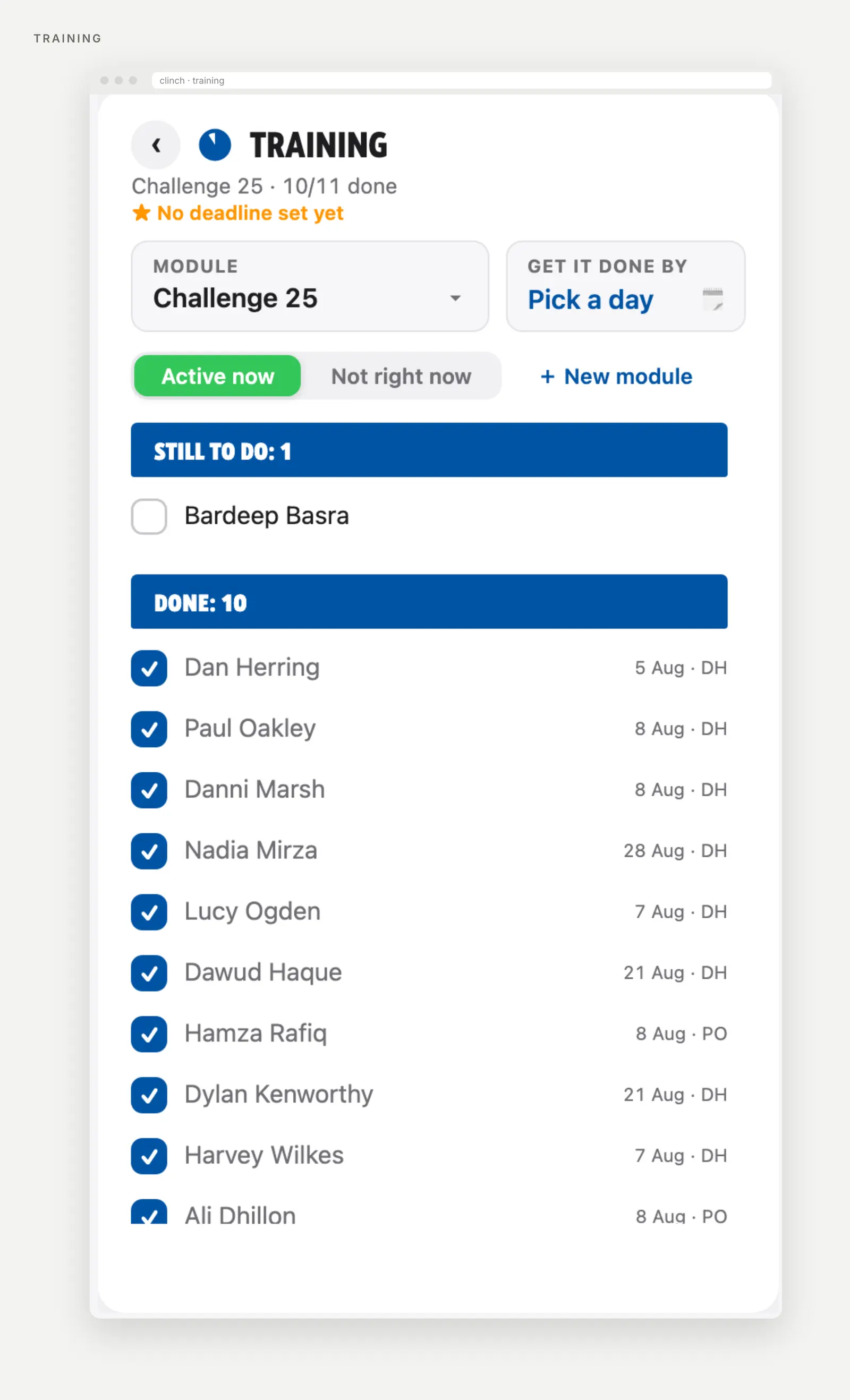

Daily checks reset tomorrow. Training stays done. A compliance module runs for weeks, carrying its own people list and its own deadline.

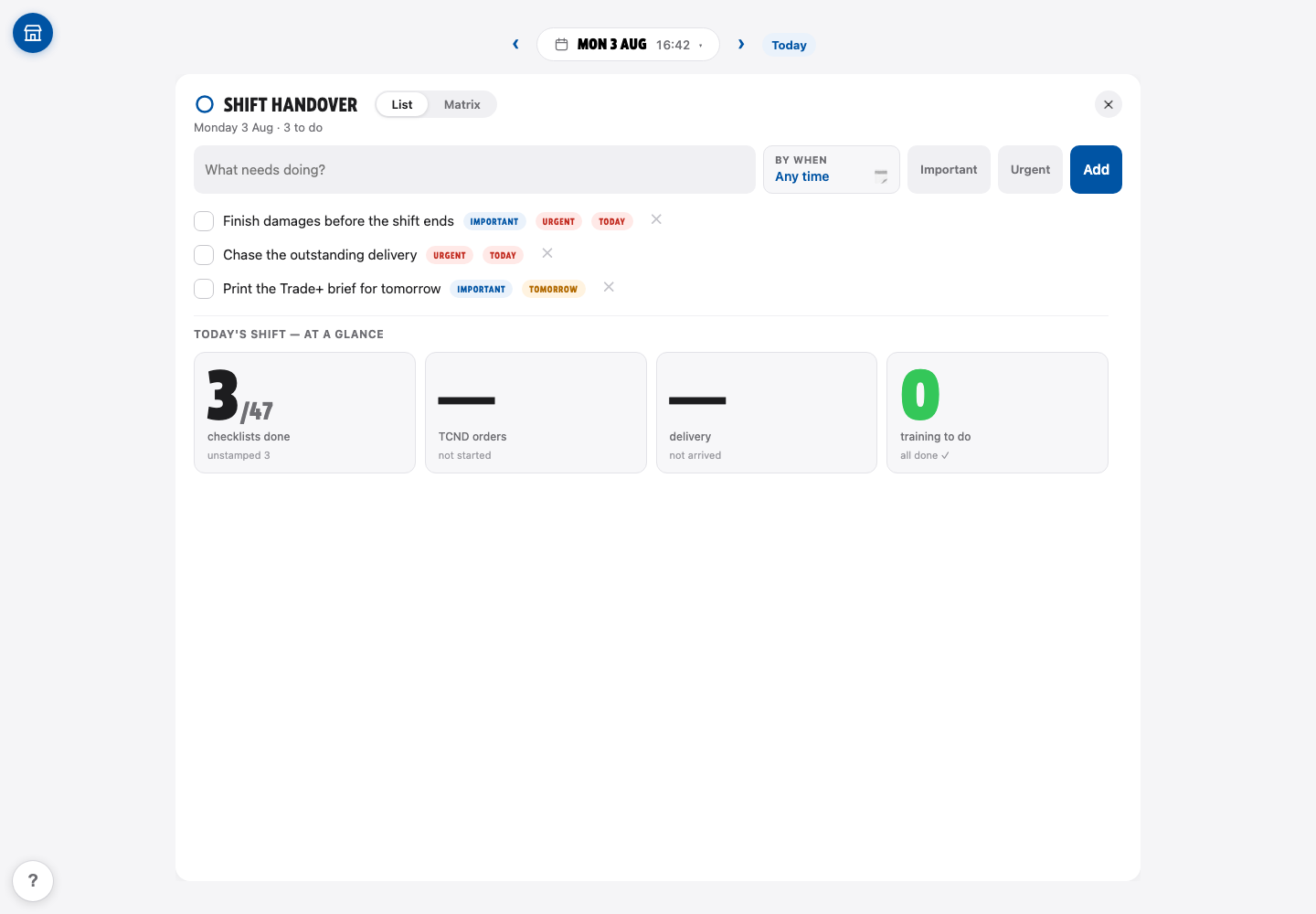

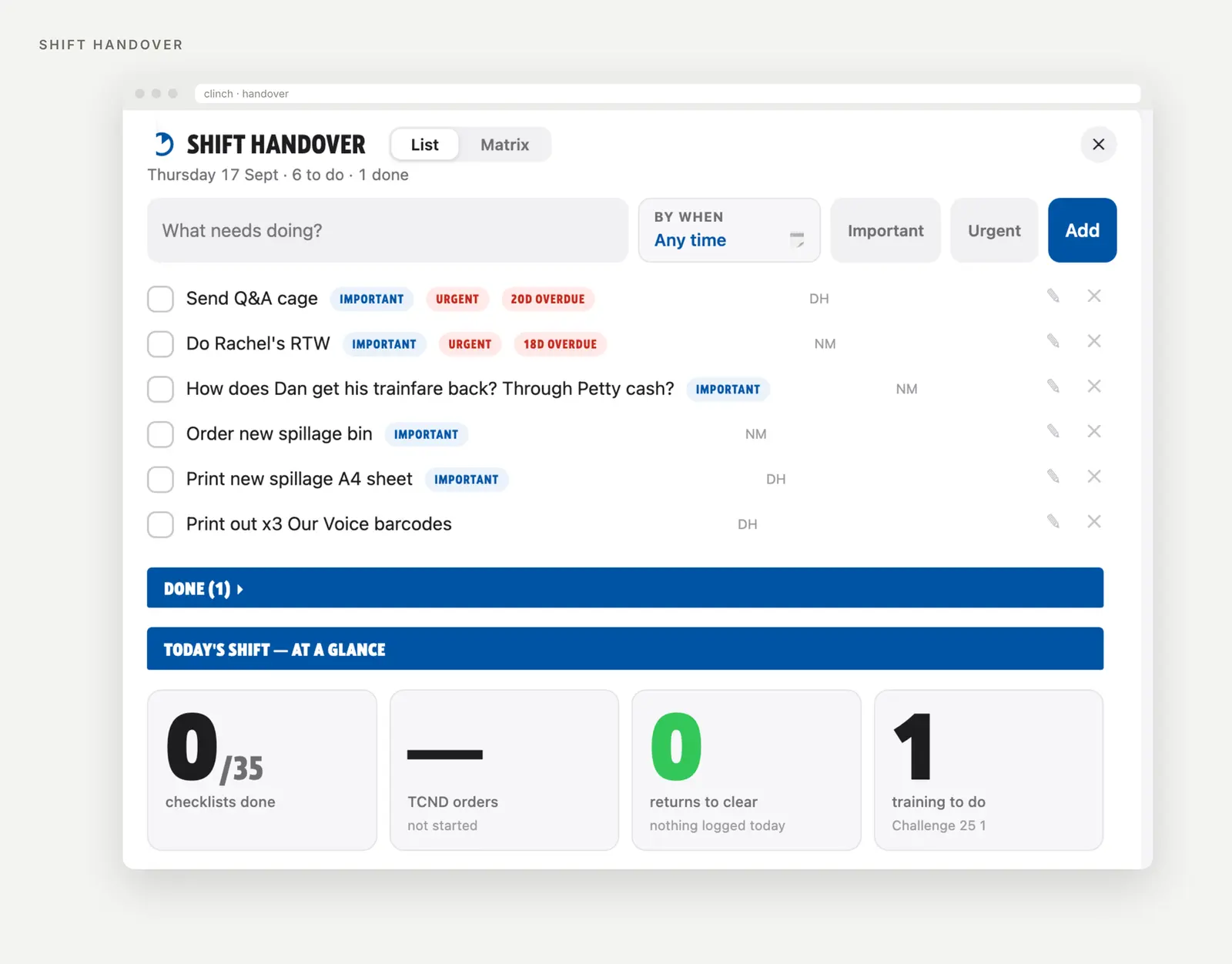

Handover became a shared list that survives the date change. A job stays open until someone closes it, stamped with the date and the initials.
The next manager sees the shape of the day without opening a single block.
Clinch looks like a calendar. Its real job is memory.
To clinch a nail is to bend the point over on the far side, so it can never work back out.
What moved, and what has not
The product moved. The store number has not been read yet.
The reading will cover checklist completion, training cleared before deadline, and open audit actions.
Until then this page proves I can build it. It does not prove the next audit gets easier.
What the store taught the product
Task data is part of the design
A clean screen cannot rescue the wrong timing, vague wording or a duplicate job.
Different jobs need different memory
A fire-door check, a month-long training module and an audit action each need their own reset rule.
Delete your own ideas
The focus pill felt useful on my laptop. On the floor it stole attention from the calendar.
